Bridge Sir El Donnyeh, Qosaita & Bqarsona
This project had 3 main challenges to overcome: balancing the weight of the bridge in mid-air, the variation of the post-tension cable installation according to the construction phases, and finally the middle span, which is much longer than the adjacent spans.
- Area
- Not specified
- Year
- Not specified
- Scope
- Not specified
- Location
- Not specified
The Project
What?
This project had 3 main challenges to overcome: balancing the weight of the bridge in mid-air, the variation of the post-tension cable installation according to the construction phases, and finally the middle span, which is much longer than the adjacent spans.
How?

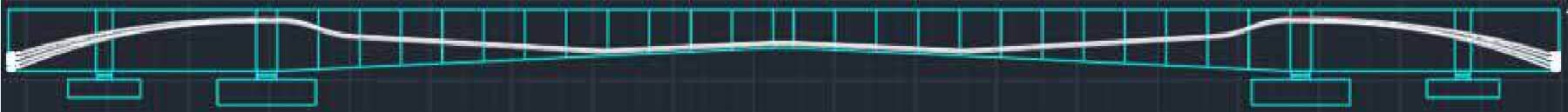

Backfill was placed as a counterweight in the back spans in closed sections. 48 cables were installed to retain the segments in the first stage, then 8 cables were added once the 2 bridges were linked in the middle, and finally continuous cables were installed from the beginning to the end of the bridge.

Next Project
RF NGO — Children Angels of Earth
